Manual S Equipment Selection Done Right | Nationwide
Residential HVAC Equipment Selection · Nationwide

Manual S Equipment Selection, Done Right

The load doesn’t pick the equipment. The equipment’s real performance at your design conditions does — and that’s rarely the number on the box.

ACCA Manual S methodology Sized to your Manual J loads Nationwide coverage

Manual S is the ACCA standard for selecting HVAC equipment to match a home’s calculated loads. It takes the heating and cooling loads from a Manual J and selects specific equipment whose real, published performance at your design conditions meets those loads — total capacity, sensible capacity, and latent capacity checked separately. It is the step that turns a load number into an actual make and model, and it is where “a 3-ton load needs a 3-ton unit” quietly goes wrong.

Key facts
  • Manual S selects equipment to match the loads a Manual J calculates — it’s the bridge between the load and the install.
  • A unit’s nameplate tonnage is its rating at standard test conditions, not at your design day — real capacity changes with outdoor temperature, airflow, and humidity.
  • Cooling equipment must meet the sensible and latent loads separately, not just the total tonnage.
  • Manual S caps how far over the load you can size — generally within about 15% for single-stage cooling — specifically to protect dehumidification and efficiency.
  • For heat pumps, selection includes the balance point and how much auxiliary heat is actually needed.

What is Manual S equipment selection?

Manual J tells you how much heating and cooling a house needs. Manual S is how you choose the equipment that actually delivers it. That sounds like simple matching — pick the unit whose tonnage is closest to the load — but it isn’t, because a piece of equipment doesn’t have one fixed capacity. Its output rises and falls with the outdoor temperature, the indoor conditions, and the airflow across the coil. Manual S is the procedure for checking a specific model’s expanded performance data at your design conditions and confirming it meets the load there — not at the lab.

Why “3-ton load, 3-ton unit” is the wrong way to size

The tonnage stamped on a condenser is an AHRI rating measured at standard conditions — roughly 95°F outdoors and a fixed indoor setpoint. Your design day might be 100°F or hotter, and as the outdoor temperature climbs, a unit’s actual cooling output drops. So a “3-ton” unit that makes 36,000 BTU/h in the lab can deliver noticeably less on the worst afternoon of the year — exactly when the house needs the most. Matching nameplate tonnage to the load ignores this entirely.

85°F 95°F (AHRI rating) 100°F design day Outdoor temperature → Capacity (BTU/h) Equipment output 36,000 (nameplate) ~33,000 on the design day Building cooling load At design, real output sits right near the load — the nameplate margin is gone.
Capacity isn’t a fixed number. The same unit makes less cooling as it gets hotter outside. Manual S checks a specific model’s real output at your design conditions — the only place the comparison to the load is honest.

How equipment is actually selected

Real Manual S selection works from the manufacturer’s expanded performance tables — the grids that show a unit’s capacity at different outdoor temperatures, indoor conditions, and airflows. We take your Manual J loads, go into those tables at your design conditions, and confirm the candidate equipment meets the load there. Then we check the three capacities that actually matter:

CapacityWhat it has to cover
Total coolingThe whole cooling load at design conditions — within the Manual S oversizing limit, not wildly above it.
Sensible coolingThe temperature portion of the load — the part that brings the air down to setpoint.
Latent coolingThe moisture portion — critical in humid climates, and the part the nameplate never mentions.
HeatingThe heating load at the winter design temperature, including heat-pump output at low temperatures.

Why latent capacity is the part that gets missed

In a hot-humid climate, a unit can have plenty of total capacity and still fail, because not all of that capacity goes toward removing moisture. Two units with the same tonnage can have very different latent performance. Manual S checks the latent capacity against the latent load specifically, so the equipment you install can actually keep the house dry — not just cold. This is exactly why oversizing is capped: a too-large unit short-cycles and never runs long enough to dehumidify, so “bigger” makes the moisture problem worse, not better.

Cooling load chart showing total cooling load as the sum of sensible load and latent load: 26,000 BTU/h sensible plus 10,000 BTU/h latent equals a 36,000 BTU/h total cooling load.
Total isn’t the whole story. A cooling load splits into a sensible part (temperature) and a latent part (moisture). Manual S sizes against the latent number too — that’s what keeps a humid house dry, not just cold.

Heat pumps: balance point and auxiliary heat

Heat pumps add a step. A heat pump’s heating output falls as the outdoor temperature drops, so there’s a temperature — the balance point — below which it can no longer keep up with the heating load on its own. Manual S identifies that balance point and sizes the auxiliary heat to cover the gap, so you don’t end up with strip heat that’s either undersized for a cold snap or oversized enough to trip the electrical service.

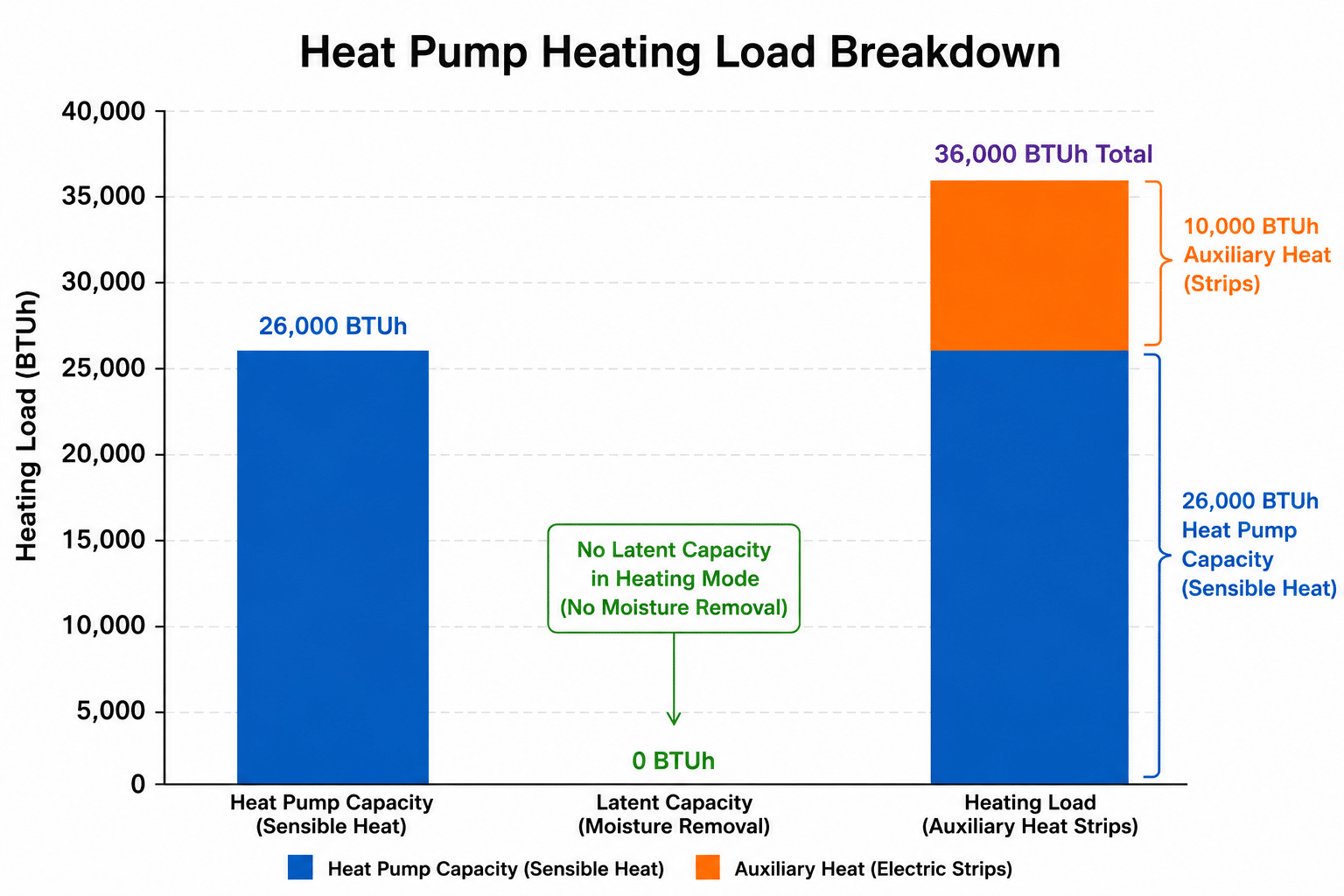

Heating load chart showing a heat pump providing 26,000 BTU/h supplemented by 10,000 BTU/h of auxiliary electric heat strips for a 36,000 BTU/h total heating output.
Where the balance point bites. Below it, the heat pump can’t cover the heating load alone — auxiliary heat strips make up the difference. Manual S sizes that gap on purpose, so the strips aren’t too small for a cold snap or big enough to overload the service.

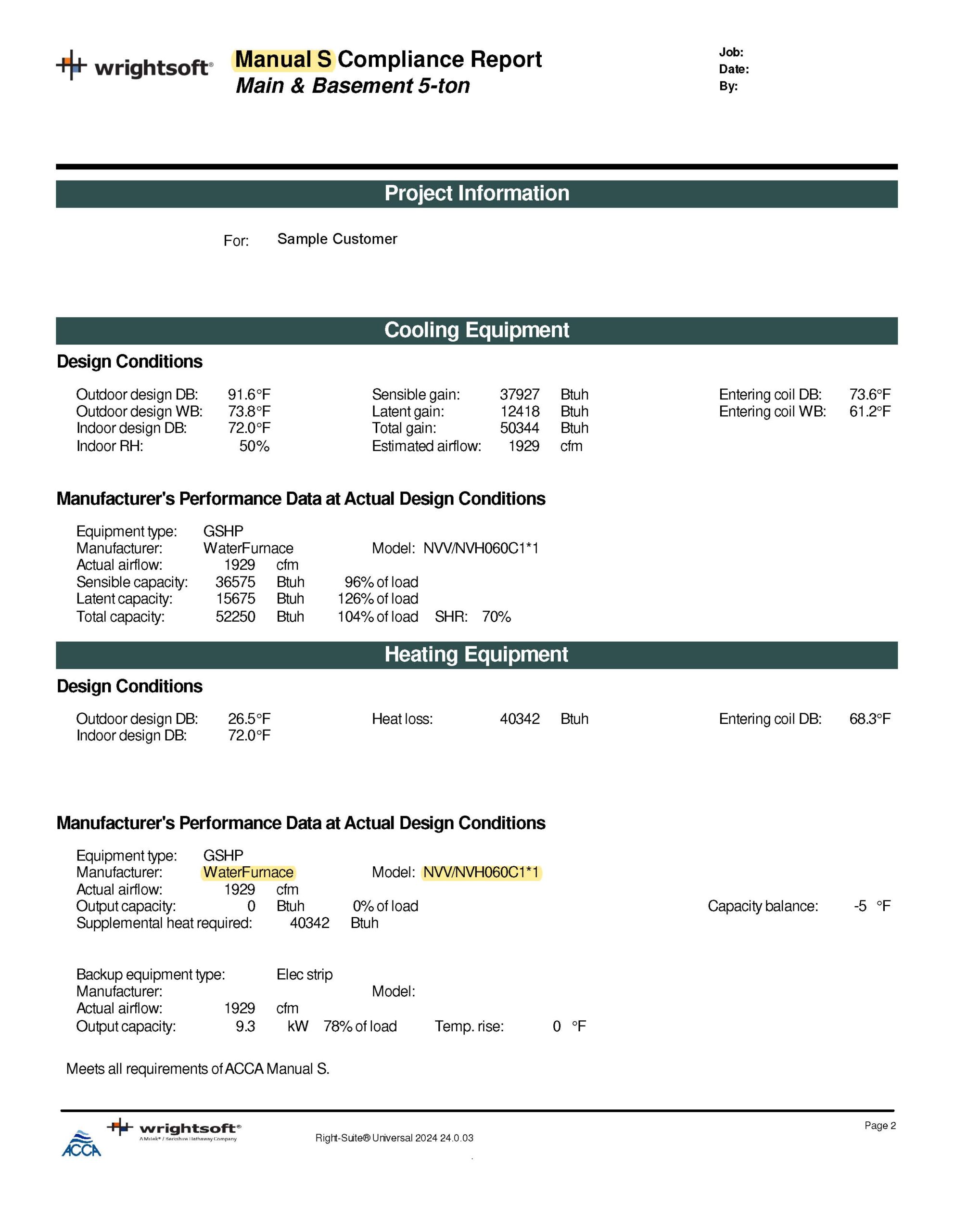

Example Manual S equipment selection report matching a 5-ton system's capacity to the calculated heating and cooling loads at design conditions for a main floor and basement.
The selection, documented. Equipment matched to the calculated sensible, latent, and heating loads at your design conditions — the report that backs up the choice at permit and inspection.

How Manual S fits with Manual J and Manual D

Manual S is the middle step of three, and it can’t stand alone:

  • Manual J — load calculation: the room-by-room loads that tell you how much capacity is needed.
  • Manual S — equipment selection: matching real equipment to those loads at your design conditions.
  • Manual D — duct design: sizing and drawing the ductwork to deliver the selected equipment’s airflow to every room.

Skip Manual S and you’re trusting a nameplate. Do it right and the equipment is matched to the house, the climate, and the worst day of the year — before anyone places an order.

Frequently asked questions

What is Manual S equipment selection?

It is the ACCA-standard method for selecting HVAC equipment whose real performance at your design conditions meets the heating and cooling loads calculated by a Manual J, checking total, sensible, and latent capacity.

Why isn’t matching tonnage to the load enough?

Because a unit’s nameplate tonnage is its rating at standard test conditions, and its real capacity falls as the outdoor temperature rises. Manual S checks the equipment’s actual output at your design conditions instead of trusting the rating.

What does Manual S check for cooling equipment?

Total cooling capacity within the allowed oversizing limit, sensible capacity for the temperature load, and latent capacity for the moisture load — all at the home’s design conditions.

How does Manual S handle heat pumps?

It finds the balance point, the temperature below which the heat pump can no longer meet the heating load alone, and sizes the auxiliary heat to cover the remaining load.

Do you provide Manual S nationwide?

Yes. Manual S is done remotely from your Manual J and the selected equipment data, for projects anywhere in the country.

Get equipment matched to the load, not the box

Manual S selection checked against real performance data at your design conditions, by someone who has done it for decades. Send us your project to start.

See pricing & start your project →
